6. Assignment of Proceeding



2011 LCR Need Based on Category C with operating procedure

    Local Area Name

Existing Capacity Needed

Deficiency

Total

(MW)

    Humboldt

188

17

205

    North Coast / North Bay

734

0

734

    Sierra

1510

572

2082

    Stockton

459

223

682

    Greater Bay

4804

74

4878

    Greater Fresno

2444

4

2448

    Kern

434

13

447

    LA Basin

10589

0

10589

    Big Creek/

    Ventura

2786

0

2786

    San Diego

3146

61

3207

Total

27094

964

28058

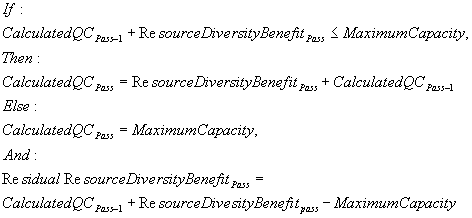

a. The Qualifying Capacity Methodology Manual in Appendix B to this decision is adopted as part of the resource adequacy program. The Energy Division shall use the Manual to calculate a 2011 net qualifying capacity list and post the results on the Energy Division's website. Each load-serving entity shall use net qualifying capacity values established according to the manual along with relevant allocations for resource adequacy (RA) credit to fulfill its resource adequacy obligation.

b. Line losses avoided by demand response (DR) resources shall be valued for the purposes of resource adequacy calculations as follows:

DR RA Value = 1.15 * DR Load Impact * (1.00/(1.00 - transmission and distribution (T&D) Line Loss Rate)) where, T&D Line Loss Rate = 3% + IOU-specific Distribution Loss Factors.

c. Full year local resource adequacy credit for Air Conditioner Cycling programs shall continue.

d. The Energy Division shall keep all resource adequacy filings and related materials for three calendar years after the end of the compliance year. The Energy Division shall generally destroy records past their retention date, but may retain records for statistical, enforcement or other purposes.

e. Load-serving entities may, at the discretion of the California Energy Commission staff, file changes to their load forecasts up to 25 days before the due date of the month-ahead compliance filings.

f. The requirement in Decision 06-06-064 that LSEs list all local resources under their control on their local RA filing is modified so that at the time of the year-ahead local filing, each LSE shall submit, in addition to its other year-ahead filings, a list of all local resources it controls (via ownership or contact) that are not listed as RA resources and committed to the CAISO up to their full NQC in the year-ahead local filing. This "additional local resource list" shall be sent to the CPUC, CAISO, and CEC. LSEs may commit resources from their additional local resource list as RA resources in order to meet residual collective local deficiencies identified by CAISO.

g. The following penalty structure for resource adequacy procurement deficiencies is adopted for violations which occur after the date of this decision:



Small Procurement Deficiency

(modifying E-4195,

Appendix A)

System Procurement Deficiency

(modifying

D.05-10-042, COL 21

and D.06-06-064,

COL 26)

Local Procurement Deficiency

(modifying

D.06-06-064,

COL 25 and COL 26)

Replaced within

five-business days of

the date of notification

$1,500 first incident

in calendar year;

$3,000 for each

incident thereafter

in a calendar year

$3.33/kilowatt (kW)-month

$3.33/kW-month

Replaced after

five-business days

from the date of

notification or not

replaced

LSE pays the

applicable System

or local RA penalty

for the deficiency

$6.66/kW-month

$3.33/kW-month

(END OF APPENDIX A)

2.1. Guide to this Document

· For wind, solar, and other non-dispatchable resources, historical production data is used. This data is obtained by subpoena from CPUC to California ISO; CPUC subpoenas data for specific resource IDs in these classifications from the classification list. CPUC subpoenas hourly "Actual Settlement Quality Meter Data" which describes the production profile for each resource. The production is measured in MWh produced per hour. This data represents the average generation (MW) over each hour and does not provide any information about intra-hour variation in generation.

· New wind, solar, and other non-dispatchable resources are considered to begin operation in the first month the resource operated before the 15th day. A resource that began producing on the 16th (or later) day of a month is considered to begin operation during the following month. The first positive values in the Actual Settlement Quality Meter Data are the sign that a resource began producing. Under this convention, no distinction is made between zero values due to a discontinuation of operation versus zero production during the normal course of operation (e.g., due to lack of fuel such as wind).

Date

Hour

Year 1 (MWh)

Year 2 (MWh)

Year 3 (MWh)

Average (MWh), Years 1 - 2

Average (MWh), Years 1 -3

Proxy Value (MWh) - Year 3

7-Mar

1

50

53

16

51.5

39.7

51.5

7-Mar

2

51

54

15

52.5

40

52.5

7-Mar

3

50

52

17

51

39.7

51

7-Mar

4

52

50

16

51

39.3

51

7-Mar

5

55

53

17

54

41.7

54

7-Mar

6

60

63

18

61.5

47

61.5

7-Mar

7

70

65

16

67.5

50.3

67.5

7-Mar

8

71

70

17

70.5

52.7

70.5

7-Mar

9

72

75

18

73.5

55

73.5

7-Mar

10

72

74

17

73

54.3

73

7-Mar

11

74

72

16

73

54

73

7-Mar

12

74

73

20

73.5

55.7

73.5

7-Mar

13

75

77

19

76

57

76

7-Mar

14

74

76

18

75

56

75

7-Mar

15

76

72

19

74

55.7

74

7-Mar

16

75

73

19

74

55.7

74

7-Mar

17

75

78

18

76.5

57

76.5

7-Mar

18

74

75

20

74.5

56.3

74.5

7-Mar

19

70

73

19

71.5

54

71.5

7-Mar

20

68

69

18

68.5

51.7

68.5

7-Mar

21

65

67

19

66

50.3

66

7-Mar

22

63

65

18

64

48.7

64

7-Mar

23

60

62

18

61

46.7

61

7-Mar

24

58

59

18

58.5

45

58.5

Jan-Mar, Nov and Dec:

HE17 - HE2198 (4:00 p.m. - 9:00 p.m.)

Apr-Oct:

HE14 - HE18 (1:00 p.m. - 6:00 p.m.)

RA Compliance Year

Hours

2011

Hour Ending (HE) 15 to HE 18

(2:00 p.m. to 6:00 p.m.)

2012 and beyond, except for programs that have a different, fixed operational period set by CPUC decision.

Jan-Mar, Nov and Dec:

HE 17 to HE 21

(4:00 p.m. - 9:00 p.m.)

Apr-Oct:

HE 14 to HE 18

(1:00 p.m. - 6:00 p.m.)

Resource Type

Load Impact Protocols Required

Event Based Resources.

Example IOU programs:

CPP

CBP

DBP

AC Cycling

OBMC

Ex Post for Event Based Resources

Protocol 7 requires impact estimates be reported in a table format. Uncertainty adjustments are not needed in the table.

Protocol 8 requires reporting for the average across all participants notified on an average event day over the evaluation period. Only the hourly load drop across all participants notified on an average event day is required; no need to provide the following details:

    · Each day on which an event was called;

    · The average event day over the evaluation period

    · For the average across all participants notified on each day on which an event was called;

    · For the total of all participants notified on each day on which an event was called.

Protocol 10 requires regression based methods (read section 4.2.2, pg 60 for an overview of regression analysis). Any suppliers choosing not to use regression as described in Protocol 10 must file an evaluation plan (Protocols 1-3) well in advance of the QC demonstration deadline.100

Ex Ante for Event Based Resources

Protocol 17 requires that ex ante estimates should be informed by ex post whenever possible.

Protocol 21 requires impact estimates be reported in a table format. Uncertainty adjustments are not needed in the table.

Protocol 22 requires the use of 1-in-2 weather year for the monthly system peak day. The 1-in-10 weather year, typical event day, or an average weekday for each month are not needed for QC calculation.

Protocol 23 requires ex ante estimates be based on regression methodologies (read section 6.2, pg 98 for guidance).

Portfolio Impacts, if Required

Protocol 24 describes methodology for estimating the impacts of multiple DR programs within a portfolio. All DR resources whose participants also participate in other DR programs (potentially operated by other entities) must follow Protocol 24; such resources should also submit an evaluation plan (Protocols 1-3).

Sampling if Required

Protocol 25 requires certain procedures to ensure that sampling bias is minimized. Protocol 25 is not anticipated to be required for most DR resources using LIPs only to demonstrate QC; DR resources with a small number of participating customers should provide data from all participants, obviating the need for sampling methodologies. For resources with enough participants to adopt a sampling methodology, an evaluation plan (Protocols 1-3) is required well in advance of the QC demonstration deadline.

Reporting Protocols

Protocol 26 lists certain sections that should be included in the evaluation reports. These reports may be limited in scope, as described above.

Non-Event

Based Resource.

Example IOU programs:

TOU

RTP

SLRP

PLS

Ex Post for Non-Event Based Resources

Protocol 14 (same as Protocol 7) requires impact estimates be reported in a table format. Uncertainty adjustments are not needed in the table.

Protocol 15 requires reporting for the monthly system peak day.

Protocol 16 requires regression based methods (read section 5.2, pg 84 for guidance). Any suppliers choosing not to use regression as described in Protocol 10 must file an evaluation plan (Protocols 1-3) well in advance of the QC demonstration deadline.

Ex Ante for Non-Event Based Resources

Protocol 17 requires ex ante estimates should be informed by ex post whenever possible.

Protocol 21 requires impact estimates be reported in a table format. Uncertainty adjustments are not needed in the table.

Protocol 22 requires the use of 1-in-2 weather year for the monthly system peak day. The 1-in-10 weather year, average weekday, or typical event day are not needed for QC calculation.

Protocol 23 requires ex ante estimates be based on regression methodologies (read section 6.2, pg 98 for guidance).

Portfolio Impacts, if Required

Protocol 24 describes methodology for estimating the impacts of multiple DR programs within a portfolio. All DR resources whose participants also participate in other DR programs (potentially operated by other entities) must follow Protocol 24; such resources should also submit an evaluation plan (Protocols 1-3).

Sampling if Required

Protocol 25 requires certain procedures to ensure that sampling bias is minimized. Protocol 25 is not anticipated to be required for most DR resources using LIPs only to demonstrate QC; DR resources with a small number of participating customers should provide data from all participants, obviating the need for sampling methodologies. For resources with enough participants to adopt a sampling methodology, an evaluation plan (Protocols 1-3) is required well in advance of the QC demonstration deadline.

Evaluation Reporting

Protocol 26 lists certain sections that should be included in the evaluation reports. These reports may be limited in scope, as described above.

SDG&E

SCE

PG&E

San Diego

Big Creek/Ventura

Greater Bay Area

System (no local area)

LA Basin

Other PG&E local areas



System (no local area)

System (no local area)

Program Total

Program Total

Program Total

Acronym

Definition

CAISO ID

California ISO Scheduling Resource ID

California ISO

California Independent System Operator

CEC

California Energy Resources Conservation and Development Commission

CPUC

California Public Utilities Commission

HE

Hour Ending

IOU

Investor Owned Utility

kW

Kilowatt

kWh

Kilowatt-hour

LGIP

Large Generator Interconnection Procedures

LIP

Load Impact Protocol

MW

Megawatt

MWh

Megawatt-hour

NQC

Net Qualifying Capacity

PMax

Maximum Power Plant Output

QC

Qualifying Capacity

RA

Resource Adequacy

SAS®

Statistical Analysis Software

SC

Scheduling Coordinator

SGIA

Small Generator Interconnection Agreement

SGIP

Small Generator Interconnection Procedures

SLIC

Scheduling and Logging for ISO of California

78 http://www.caiso.com/14d4/14d4c4ff59780.html.

79 See Appendix U of the California ISO Tariff: http://www.caiso.com/2471/2471994c26350.pdf. See also: Section 5.1.3.4 of CAISO's Business Practice Manual for Reliability Requirements: https://bpm.caiso.com/bpm/bpm/version/000000000000011.

80 The exception to this rule is reduction in deliverability caused by any degradations of the transmission system which are not repaired promptly, for example due to fires or other force majeure events.

81 http://www.caiso.com/23d7/23d7e41c14580.pdf.

82 CAISO Tariff Appendix A, Fourth Replacement Volume No. 2, Sheet No. 863: http://www.caiso.com/2471/2471974a121c0.pdf.

83 See Appendix S to the California ISO Tariff: http://www.caiso.com/2471/247198fe24690.pdf.

84 SGIA interconnections use the Wholesale Distribution Access Tariff (WDAT).

85 The scheduled outage criterion was adopted by D.06-07-031. For more information, see Section 13 of the 2010 RA Guide: http://www.cpuc.ca.gov/NR/rdonlyres/14DFD39E-40C6-4FAF-8C36-38F8708BC23A/0/RAGuide2010.doc.

86 See Sections 8 and 9.

87 D.09-06-028 at 29.

88 For more information about SLIC, see: http://www.caiso.com/docs/2005/10/28/200510281047542112.html.

89 See Error! Reference source not found.

90 See also, Section 5 of CAISO's Business Practice Manual for Reliability Requirements: https://bpm.caiso.com/bpm/bpm/version/000000000000011.

91 California ISO coordinates with SCs for resources to schedule PMax tests at a time selected by the SC. Generally, SCs select the timing of a PMax test to demonstrate output of the resource at or near its maximum possible output.

92 See http://www.caiso.com/1796/179697c864850.xls.

93 Adopted in D.09-06-028, Appendix C.

94 The production profile in the figure is generated randomly and is not intended to represent any particular resource or classification of resources.

95 For more information about SAS®, see http://www.sas.com/technologies/analytics/statistics/stat/index.html.

96 See Error! Reference source not found.

97 See the description of the PCTLDEF=1 at: http://support.sas.com/documentation/cdl/en/procstat/59629/HTML/default/procstat_univariate_sect028.htm.

98 HE indicates "hour ending", or the 60 minutes that end at the numbered hour, in 24 hour time. For example, HE17 indicates the 60 minutes beginning at 16:00
(i.e. 4:00 p.m.) and ending at 16:59.

99 The LIPs are detailed in Appendix A to D.08-04-050; http://docs.cpuc.ca.gov/WORD_PDF/FINAL_DECISION/81979.PDF.

100 The deadline is typically April 1.

101 If assumptions underlying the LIP estimates for a particular program are unreasonably optimistic, CPUC staff accordingly reduces the load impacts.
