Word Document PDF Document

DGX/KLM/dhn 4/7/2006

BEFORE THE PUBLIC UTILITIES COMMISSION OF THE STATE OF CALIFORNIA

In the Matter of the Application of San Diego Gas & Electric Company (U 902 E) for a Certificate of Public Convenience and Necessity for the Sunrise Powerlink Transmission Project.

Application 05-12-014

(Filed December 14, 2005)

RULING OF ASSIGNED COMMISSIONER AND ASSIGNED ADMINISTRATIVE LAW JUDGE DENYING THE MOTION OF SAN DIEGO GAS & ELECTRIC COMPANY AND SETTING FURTHER PROCEDURAL STEPS

Summary

This ruling denies the motion of San Diego Gas & Electric Company (SDG&E) to initiate an evaluation of the need for its proposed Sunrise Powerlink project in this proceeding prior to SDG&E's filing of its Proponent's Environmental Assessment (PEA) and related information required by General Order (GO) 131-D, Rule 17.1 of the Commission's Rules of Practice and Procedure (Rules), and Public Utilities Code Section (§) 1003. Based on recent filings by SDG&E indicating that they will be amending their application in July 2006, we are unable to proceed absent such amendments and the motion is effectively moot.

We remain committed to issuing a timely decision in this proceeding. To that end, we list herein specific actions that we direct be taken to attempt to process the case consistent with the aggressive timeline SDG&E has proposed in its application and to avoid delay in the projected online date for the project, were it to be approved.

Background

SDG&E filed this application for authority to construct a 500 kilovolt (kV) transmission line omitting some of the information required by § 1003,
GO 131-D, and Rule 17.1 of our Rules.1 SDG&E stated its intent to provide the Proponent's Environmental Assessment and other required information after it had determined a precise project path and conducted the necessarily environmental review, which it expects will be ready in July 2006. SDG&E's application included a motion seeking Commission approval to defer filing of the required information, asking the Commission to explore the issue of project need in advance of SDG&E's providing the outstanding project information, and requesting issuance of a Commission decision on need before completion of the Commission's California Environmental Quality Act (CEQA) analysis.

On February 10, 2006, the Assigned Commissioner issued a ruling (Ruling) in this proceeding following a prehearing conference on January 31, 2006. The Ruling sought briefs addressing SDG&E's motion and solicited responses to eight questions, four factual questions for SDG&E and four questions for all parties, including SDG&E, to address.2

The following parties filed responses to the Ruling on February 24, 2006: SDG&E, the Division of Ratepayer Advocates (DRA), the Center for Biological Diversity and the San Diego Chapter of the Sierra Club (CBC/Sierra Club), the City of San Diego (City), Coral Power, Duke Energy North America (Duke), PPM Energy, Imperial Irrigation District (IID), and Ramona Alliance Against Sunrise Powerlink (RAASP). Generally, Coral Power and PPM Energy support SDG&E's motion, while the remaining parties oppose it.

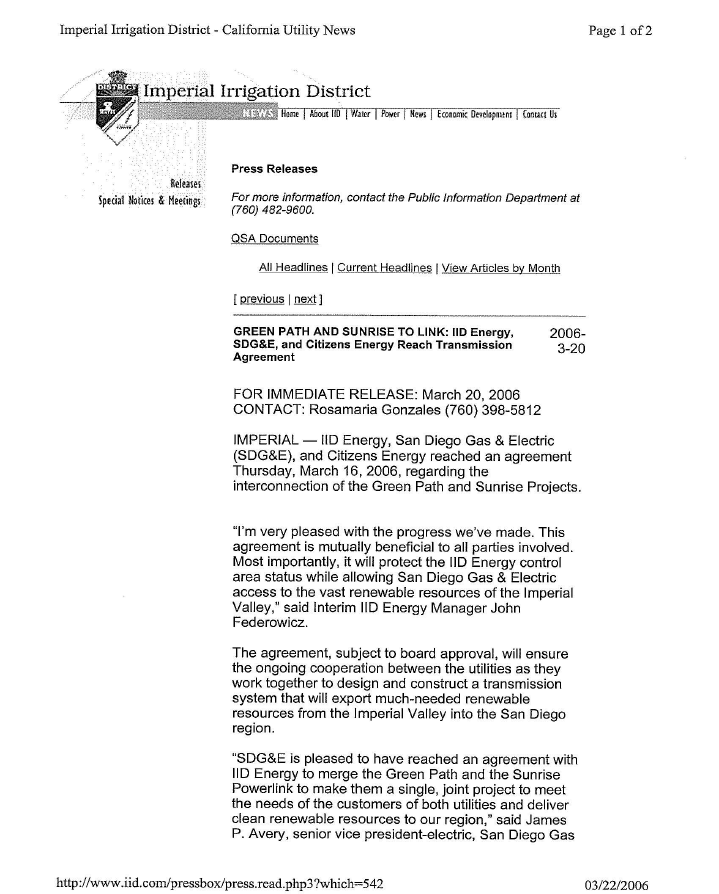

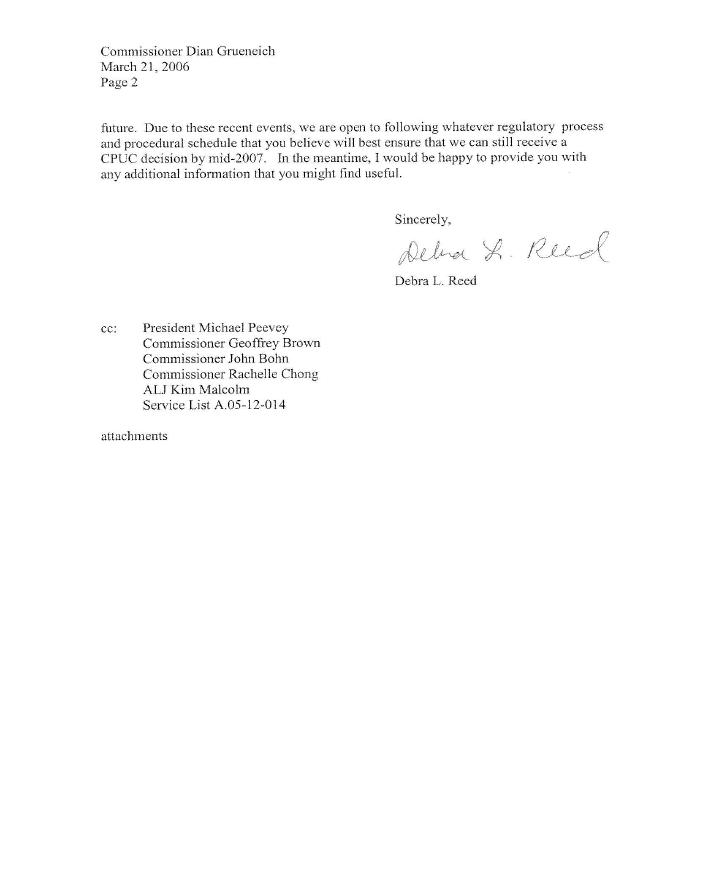

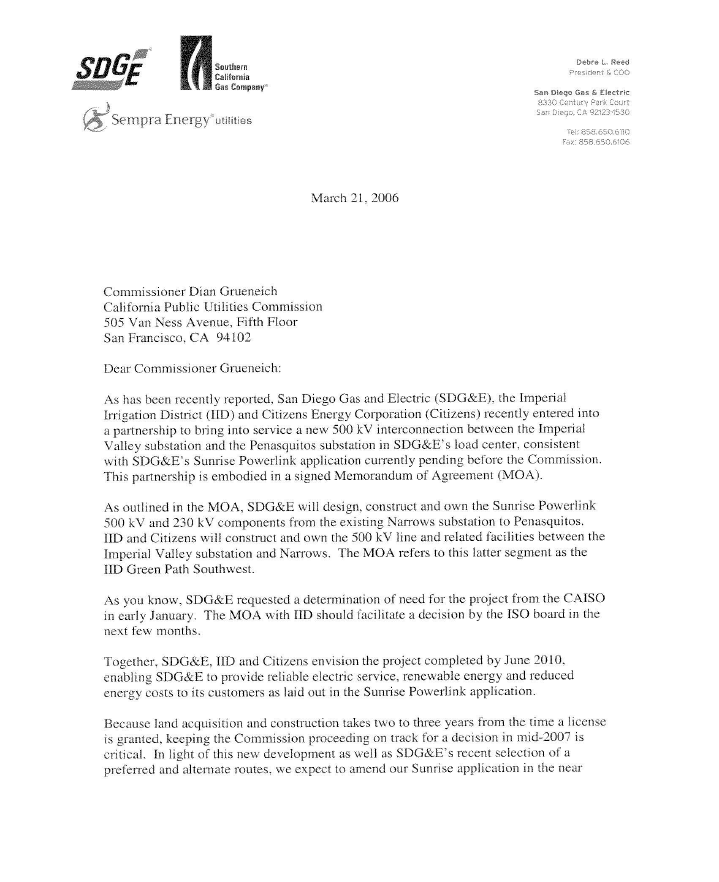

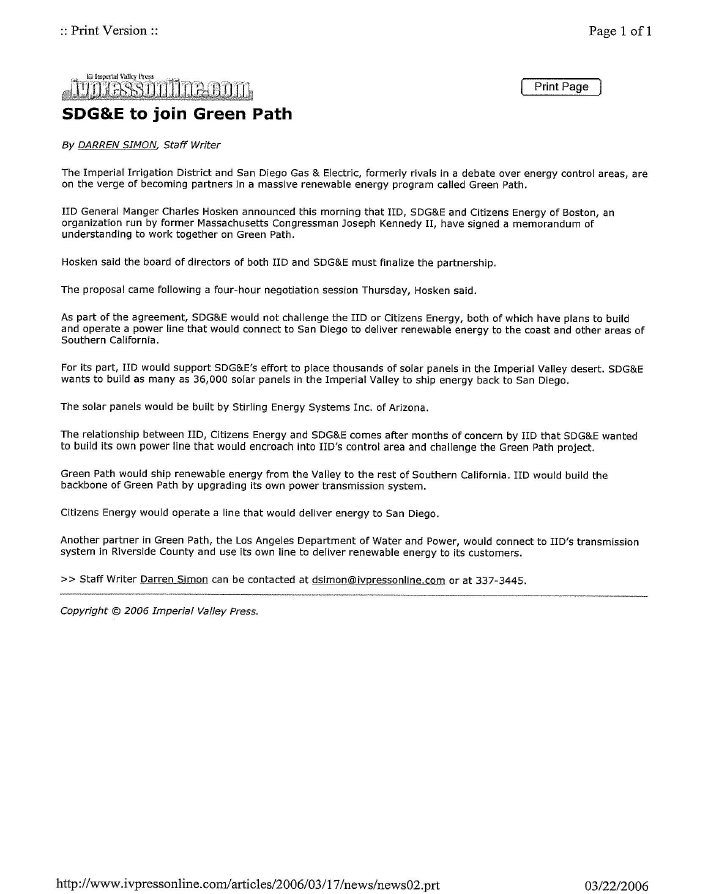

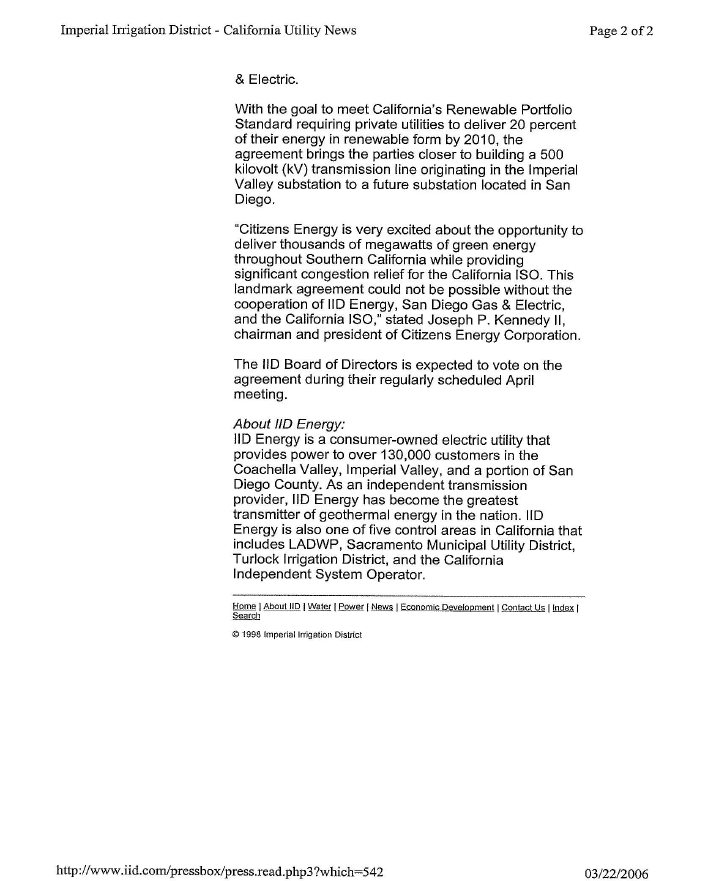

On March 22, 2006, SDG&E submitted to the Commission, and to the service list for this proceeding, a letter from a corporate officer dated March 21st, an IID press release dated March 20th, and a press clipping dated March 17th, indicating that they had entered into a memorandum of agreement (MOA) with IID to form a partnership for building a portion of the proposed Sunrise project and were open to whatever regulatory process and procedural schedule the Commission deemed necessary, with SDG&E's focus on meeting their proposed mid-2007 target date for a final Commission decision. These documents are attached to this ruling as Appendix A.

On April 5, 2006, SDG&E submitted to the Commission, and to the service list for this proceeding, a second letter dated April 4th and a copy of the MOA referenced in the March 21st letter. This second letter stated that SDG&E expects to amend its application in July 2006, including updates to the economic analysis of the project included in the application and the completed PEA. In addition, SDG&E states that that the California Independent System Operator (ISO) will have completed its review by July, allowing the ISO's analysis and determination to be considered by the Commission after that time. These documents are attached to this ruling as Appendix B.

SDG&E's Response to the Ruling & Responses in Support of SDG&E's Motion

In its response to the Ruling, SDG&E explained that it is proposing that the Commission consider the issue of project need in a Phase 1 of the proceeding and adopt a decision on need by the 3rd quarter of 2006. Under SDG&E's proposal, this decision would be interim for the purposes of considering rehearing and court challenges but irrevocable and not subject to re-litigation in a Phase 2, absent new factual information, when CEQA review would be conducted. Both Phase 1 and Phase 2 would consider project alternatives, including the no-project alternative, and the Phase 1 record would inform the Phase 2 record. SDG&E believes consideration of project need concurrent with the CEQA review could delay the issuance of a final decision on the project.3

In response to concerns that SDG&E's procedural proposal is unlawful, SDG&E argues that that the courts have granted the Commission great deference in statutory interpretation and procedural matters. SDG&E states the Commission has issued a finding of need in advance of its CEQA review in several cases, including the Mission Miguel transmission project, the Otay Mesa Power Purchase Agreement transmission project, and the Devers-Palo Verde 2 transmission project.

PPM Energy and Coral Power, which state their desire to utilize the proposed line to provide access to newly developed projects or to relieve congestion between San Diego's load center and their existing projects, support SDG&E's motion.

Responses in Opposition to SDG&E's Motion

The parties opposing SDG&E's motion, including DRA, the City, CBC/Sierra Club, Duke, IID, and RAASP, emphasize different concerns but share a common view that the Commission does not have discretion to make a finding of need before completing its review of the environmental aspects of the project, and that it cannot conduct a reasonable need assessment without the project information required by GO 131-D, Rule 17.1, § 1003, and CEQA. Some raise concerns that the issue of need cannot be evaluated until all affected parties receive official notice of the project, which the utility cannot provide until it has determined a specific route. Several observe that although the Commission has considerable flexibility to craft its procedures, it does not have discretion to waive statutory requirements.

Discussion

After review of all filings, we deny SDG&E's motion because it is moot. SDG&E's two recent letters to the Commission and the recently completed MOA with IID demonstrate that the Sunrise Powerlink, as currently proposed in this application, has and will be altered in the future, making initiation of our review at this time unnecessary. In particular, SDG&E has indicated that the evidence it will present with regard to project need will change. It would be imprudent for the Commission to undertake a factual consideration of the application in this proceeding when the applicant has indicated that they expect to significantly alter that filing in four months time.

Consistent with Rule 7(c), parties making written ex-parte communications are required to file formal notices of those communications within three days, in addition to simultaneously serving such communication on the service list. Future letters and electronic communications to decision-makers should be reported consistent with our rules and we herein direct SDG&E to file notices for the letters it has sent to the Commission's decision-makers thus far, consistent with our Rules. In addition, we remind SDG&E that the Commission's processes are formal and that letters to the Commission are not the required form of communication on procedural matters and SDG&E should adhere to these requirements.

Next Steps

For purposes of administrative convenience and to keep the proceeding on track, we will keep this docket open, and permit SDG&E to amend its application with the additional required information, including the PEA. Pursuant to
Rules 44.1 and 2.6, parties will have 30 days to protest the amended application, and, pursuant to Rule 44.6, the applicant has 10 days to reply to any protests or responses. The rights of parties that have already protested the application and choose not to protest the amended application will be preserved. We commit the Commission to reviewing the application expeditiously once SDG&E provides the required information. In order to proceed expeditiously, we direct parties to follow the seven steps listed below:

IT IS RULED that

Dated April 7, 2006, at San Francisco, California.

CERTIFICATE OF SERVICE

I certify that I have by mail, and by electronic mail, served a true copy of the original attached Ruling of Assigned Commissioner and Assigned Administrative Law Judge Denying the Motion of San Diego Gas & Electric Company for the Commission to Investigate and Rule on Project Need in Advance of Receiving Project Information Required by Statute and Commission Rules to all parties of record in this proceeding or their attorneys of record.

Dated April 7, 2006, at San Francisco, California.

NOTICE

Parties should notify the Process Office, Public Utilities Commission, 505 Van Ness Avenue, Room 2000, San Francisco, CA 94102, of any change of address to insure that they continue to receive documents. You must indicate the proceeding number on the service list on which your name appears.

* * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * * *

The Commission's policy is to schedule hearings (meetings, workshops, etc.) in locations that are accessible to people with disabilities. To verify that a particular location is accessible, call: Calendar Clerk (415) 703-1203.

If specialized accommodations for the disabled are needed, e.g., sign language interpreters, those making the arrangements must call the Public Advisor at (415) 703-2074,

TTY 1-866-836-7825 or (415) 703-5282 at least three working days in advance of the event.
