· Process used (Enhanced Daily Process, Defined Batch Process, or Bulk Project offering)


· Type of hot cut requested (FDT, CHC or IDLC)


· Time of cut (normal business hours, expanded hours, or premium hours)140


· Enhanced Daily Process - FDT Basic Option $14.70


· Enhanced Daily Process - CHC Basic Option $20.73


· Enhanced Daily Process - IDLC Basic Option $79.09


· Defined Batch Process - FDT Option


- Basic (M-F, 8 AM - 5 PM) $10.61


- Expanded (M-F 6 AM - 8 AM) $10.74


· Defined Batch Process - CHC Option


- Basic (M-F, 8 AM - 5 PM) $12.70


- Expanded (M-F 6 AM - 8 AM, 5 PM - 12 AM,
Sat 8 AM - 5 PM) $12.75


· Defined Batch Process - IDLC Option


- Basic (M-F, 8 AM - 5 PM) $77.35


- Basic (M-F, 8 AM - 5 PM) $10.58


    - Expanded (M-F 6 AM - 8 AM, 5 PM - 12 AM,
    Sat 8 AM - 12 AM) $10.71


    - Premium (M-F 12 AM - 6 AM,
    Sat 12 AM - 8 AM)141 $11.31


- Basic (M-F, 8 AM - 5 PM) $12.67


    - Expanded (M-F 6 AM - 8 AM, 5 PM - 12 AM,
    Sat 8 AM - 12 AM) $12.72


    - Premium (M-F 12 AM - 6 AM,
    Sat 12 AM - 8 AM)142 $13.56


- Basic (M-F, 8 AM - 5 PM) $77.33

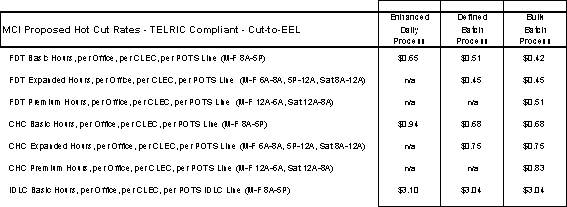

Order Flow Through applies solely to the OSS ordering function, not the OSS provisioning function. In other words, Order Flow Through measures only how the competing carrier's order is transmitted to the incumbent's back office ordering systems, not how the incumbent ultimately completes that order. (Performance Measures Proposed Rulemaking, 13 FCC Rcd at 12,849, ¶ 71 (emphasis added).)

Verizon's Proposed Hot Cut Price Structure



Ordering

Ordering

Ordering



Semi-



Description

Manual

Mechanized

Mechanized



Hot Cut Coordinated



Conversions



2-Wire WPTS



Coordination Hot Cut



"Basic"

Initial

$89.06

$86.04

$69.31

"Basic"

Additional

$58.35

$58.35

$58.35



4-Wire WPTS



Coordination Hot Cut



"Basic"

Initial

$123.55

$120.52

$101.90

"Basic"

Additional

$90.94

$90.94

$90.94



Large Job (Project)




Initial

$81.75

$78.72

$37.59



Additional

$26.63

$26.63

$26.63

Batch Hot Cut




Initial

$58.30

$55.28

$24.37



Additional

$22.75

$22.75

$22.75

WPTS Coordination



Expedite



$18.99

$18.99

$18.99

IDLC Surcharge




Initial

$150.49

$150.49

$150.49



Additional

$131.00

$131.00
