Word Document PDF Document

1 Procedural Background

2 Timing and Reporting Issues

3 Phase-In

3.1 EQUAL INCREMENTS

3.2 FAST PHASE-IN

3.3 SLOW EARLY THEN LARGER INCREMENTS

4 Load Forecasting

4.1 LOAD INFORMATION EACH LSE MUST SUBMIT

4.2 ADJUSTMENT OF PEAK LOAD FORECASTS FOR COINCIDENCE

4.3 ASSIGNMENT OF LOAD RESPONSIBILITY TO LSES

4.4 INCLUSION OF LOSSES IN LOAD FORECASTS

4.5 INCLUSION OF ENERGY EFFICIENCY SAVINGS IN LOAD FORECAST

4.6 INCLUSION OF CUSTOMER SIDE DISTRIBUTED GENERATION IN LOAD FORECAST

5 Calculation of Qualifying Capacity

5.1 INCORPORATION OF FORCED OUTAGE FACTOR INTO QUALIFYING CAPACITY OF LSE OWNED/CONTROLLED RESOURCES

5.2 ENERGY LIMITED UNITS

5.3 QUALIFYING CAPACITY FORMULAS FOR EXISTING QUALIFYING FACILITY CONTRACTS

5.4 DWR CONTRACTS

5.5 CONTRACTS

5.6 ESTIMATING LOAD REDUCTIONS FROM DEMAND RESPONSE PROGRAMS

5.7 TIMING OF WHEN TO COUNT RESOURCES UNDER CONSTRUCTION

6 Deliverability

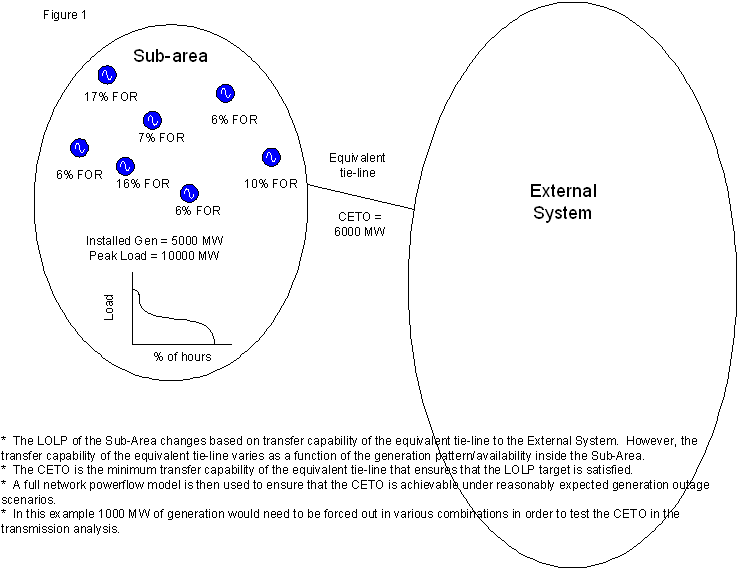

6.1 BASELINE ANALYSIS OF DELIVERABILITY OF RESOURCES TO CAISO CONTROL AREA AND AGGREGATE OF LOAD

6.2 HOW SHOULD "DELIVERABILITY" BE ALLOCATED TO EXISTING RESOURCES IF DELIVERABILITY TO AGGREGATE OF LOAD IS CONSTRAINED?

6.3 ALLOCATION OF TOTAL IMPORT CAPACITY

6.4 IS THERE A RESOURCE ADEQUACY REQUIREMENT IN LOAD POCKETS?

7 Other Topics Discussed at Workshop

7.1 MULTI-YEAR FORWARD CONTRACTING REQUIREMENT

7.2 ALLOCATION OF DWR CONTRACTS TO ALL LSES

7.3 CAPACITY TAGGING

1 Throughout the course of the workshops, many parties prepared straw proposals for discussion purposes. Some, but not all, of these materials are included in the workshop report when the document provides a helpful summary of the issues, reflects consensus discussions, or is fairly technical in nature. Inclusion or exclusion of a particular document should not be taken as any indication of approval of any position expressed in the document, but rather a judgment by the workshop moderator on whether inclusion of the document in the workshop report added additional information necessary for the Commission to decide the issues before it. 2 At the May 18 workshop, the parties discussed two capacity "tagging" proposals. Tagging is a way of identifying resources that have met all the requirements of the counting and deliverability protocols the Commission adopts and thus facilitates the demonstration of compliance with resource adequacy requirements. Capacity tagging is discussed in more detail in Section 7.3. 3 At the workshop, the discussion appeared to assume that the CEC would review forecasts and perform any necessary reconciliation or allocation, although no statement of agreement occurred regarding this responsibility. (See Section 4 below.) 4 This projection is for the second year the analysis is performed. The CAISO assumes that the first year analysis and development of baseline assumptions will take at least six months to complete. See discussion of Deliverability (Section 6 below) for more discussion of the analysis and data requirements. 5 A concern generic to all phase-in options identified is that without knowing which existing resources will "count" for meeting the year-ahead 90% resource adequacy requirement, there is a significant amount of uncertainty about the pool of resources that will be available to satisfy the 15-17% reserve requirement. The criteria for "counting" are discussed in Section 5 below. The workshop moderator notes that resources that do not meet these criteria for the year-ahead 90%forward commitment requirement may still be eligible to meet the 15-17% reserve requirement by filling in the remaining reserve requirement after the 90% forward commitment is met. 6 This topic was discussed at the May 17, 2004 workshop. On May 14, 2004, the Western Power Trading Forum filed a petition to modify the January 1, 2008 date for meeting the 15-17% planning reserve requirement. A draft interim opinion issued on June 8, 2004 dismisses the petition without prejudice. The issue is before the Commission for consideration in Rulemaking 04-04-003. 7 The workshop moderator believes that this lack of clarity stems from the fact that LSE's have identified their short-term reserve requirement goals in other procurement filings, but no goal is adopted for 2004 or 2005 for the required reserve margin. 8 The parties did not agree upon who should perform this assignment, but the CEC and CAISO were both mentioned as potential independent entities who could perform this assignment/reconciliation. 9 Energy Service Providers (ESP) believe aggregate counts of customers should be sufficient to satisfy this requirement. 10 The load forecasting working group recommends that all LSE-specific hourly load forecasts are confidential and access to such data will follow the usual non-disclosure agreement practices. At some level of aggregation, loads are no longer confidential and such "higher level" results can be prepared and released by the reviewing entity(s). No discussion of at what level of load aggregation shifts from confidential to public has yet taken place. 11 Appendix B also describes a supplemental analysis that could provide additional information to assist in interpreting the results of the analysis. Some parties supported performing the supplemental analysis but others believe it is a very difficult analysis to perform. 12 Pooling is discussed in Section ? below. 13 Parties agreed that inclusion of a provision in the contract that allows for interruption to serve the seller's native load, in the context of a force majeure situation, does not automatically exclude the contract for counting towards the resource adequacy requirement. 14 The CAISO expressed concern that this requirement would still allow for the seller to curtail its deliveries to meet native load requirements. The CAISO stated that it needs to research what triggers the right to curtail to meet native load, and depending on the outcome of that research, they could agree to the definition for import contracts to count. In addition, the CAISO indicated that it is concerned that WSPP Schedule C has an element that allows substitution of financial payment for failure to deliver. The CAISO indicated it needed to do more research on whether WSPP Schedule C would meet the definition of "economic reasons" before agreeing to this definition for import contracts to count. 15 Parties agree that contracts that are curtailable for economic reasons (e.g., spot energy and capacity) should not count towards meeting the 90% forward contracting requirement. For this reason, the workshops did not address the availability of spot market energy and capacity. The workshop moderator believes that the issue of availability of spot market energy and capacity could better be addressed in the context of long term planning objectives and evaluation of whether the 90% forward contracting requirement is too high or too low given the availability of spot market energy and capacity. 16 The ISO expressed a general concern about generation resources reducing the load forecast but did not further elaborate with respect to customer side generation. 17 For new resources less than 50 MW in size, it is incumbent on the owner/developer to provide the requisite information to the appropriate regulatory body to assess whether the resource's output constitutes qualifying capacity for purposes of the year-ahead resource adequacy showing. See Section 5.7 for more discussion. 18 Parties agreed in concept that projects under construction should be counted but did not reach agreement on when they should begin to count. The issues surrounding the timing of counting resources under construction is discussed below. 19 These requirements are only for supply resources, demand response programs with limitations on their use are addressed in Section 5.6.1 below. 20 San Diego Gas & Electric Company (SDG&E) would reflect this factor on an individual QF basis, SCE and Pacific Gas and Electric Company (PG&E) would reflect it on a portfolio basis. 21 The peak period for which historical QF performance would be measured was not defined or discussed at the workshop. QF Standard Offer 1 contracts define the on-peak period as "noon to 6:00 p.m. summer weekdays except holidays." To arrive at a measure of "historical performance at peak" you would also need to decide the number of years over which to average historical performance and whether to use performance data for a single annual peak day or five monthly peak days (May-September). For example, if you used 5 years of monthly peak day data to determine the historical performance at peak, average performance would be measured over 150 hours (6 hour on-peak period * 5 years * 5 peak days per year). 22 Portfolio basis was recommended for administrative ease, but this could also be calculated on an individual unit basis in the same way as Group A resources. 23 The time period for measuring historical performance was not defined. 24 Parties generally agreed that new and future wind contracts (including non-QF contracts) should be counted the same way as existing QF contracts for purposes of assessing resource adequacy. 25 Peak hours were not defined. 26 Portfolio of resources contracts have multiple generation units identified that the contract holder can use to meet its contract obligations. 27 These figures are for contracted capacity in 2008. 28 At the workshop, Constellation Energy agreed to provide contract language of this type of contract, but as of today's date, the workshop moderator has not received this language. 29 Although this issue was initially a concern for system imports, it appears to be less of a concern with respect to system imports than intra-control area system sales because of fact that the Pacific Northwest is a winter peaking system. 30 On June 11, 2004 the workshop moderator received the results of the CAISO calculations. The table is included as Appendix G. 31 This belief is based on anecdotal information, not a systematic study of online date projections a year-ahead and actual online dates. 32 The exceptions appear to be existing transmission contracts and self-scheduled resources. 33 The CAISO states that resources relied on for the resource adequacy showing need to be turned over to its control in order to operate the system closer to real time. This request by the CAISO highlights once again that year-ahead resource adequacy requirements may have potential interactions with system operation. The interaction issue was not addressed in workshops. 34 The subjects in Attachments 1 and 2 of Appendix D were discussed at the workshops, the merits of Attachment 3 were not discussed because parties could not agree whether it was necessary to test deliverability of resources to transmission constrained areas, see Section 6.4. 35 The approach described in Appendix E was discussed at the May 5, 2004 workshop. 36 Parties agree that because the interconnection process is overseen by FERC, the entity that performs the interconnection deliverability study will be decided by FERC. 37 Historical utility resource plans on file with the Commission were suggested as a data source for determining firm resources prior to the existence of the CAISO. Once the CAISO came into existence, interconnection studies would be the data source for determining how firm a generator's transmission is. 38 This discussion occurred at the April 12 and 13, 2004 workshops. At the May 5, 2004 workshop, the parties appeared to agree that once an allocation is made and is being utilized, that capacity does not need to be reallocated in subsequent years, as long as the contract using that path still exists. Because of the difference in discussion between the two workshops, the workshop report covers the discussion, assuming the dispute still exists, but parties should comment on whether the discussion at the May 5, 2004 workshop resolved this issue. 39 Existing commitments were not specifically defined but appear to mean firm resources using the import paths, not economy energy use of the line. 40 All parties appear to agree that adopting a local procurement requirement could trigger market power concerns and suggest that market power mitigation measures must be concurrently pursued if a local procurement requirement is adopted. This solution was discussed briefly, but cannot be characterized as an agreement by all parties. 41 This could be defined as the Capacity Transfer Limit which is described in Attachment 3 to Appendix D. 42 Although it was not discussed in any detail at the workshop, this same issue applies to utility retained generation and QF capacity. It is the belief of the workshop moderator that, unless directed otherwise, the utilities plan to rely on retained generation based on their ownership share in the facility and QF contracts that they are parties to for purposes of their year-ahead showing. 43 Parties noted that right now, the electricity market is an energy product market, not a capacity market. 44 The SVMG proposal was filed as an attachment to SVMG's pre-hearing conference statement in R.04-04-003. On and is not reproduced here. The SDG&E proposal was a summary of positions that SDG&E took in testimony during hearings in R.01-10-024 and is not reproduced here. 45 The workshop moderator is not clear whether this recommendation addresses reasonableness in the context of the price that results from the capacity tag market or whether it is reasonable to utilize a capacity tag to meet resource adequacy requirements. 46 D.04-01-050, page 11 47 Footnote 6 48 As a collaborative effort to identify issues, this document does not have the endorsement of any party.

49 There may be some discussion that peak demand should be expressed in MW rather than MWh. Historically, resource planning has centered on annual peak MW. In SCE's experience, for recent recorded data, the annual peak MW and peak MWH are so close as to be interchangeable, and resource adequacy planning can be done on the basis of the forecast highest annual or monthly MWh observation.

50 See Section V.c for another option, which some parties prefer, but which other parties view as outside the scope of D.04-01-050. 51 The CEC participants suggested the CEC may end up requiring 8760 hourly loads to be filed by LSEs as part of the inputs which the industry will provide to the CEC's 2005 IEPR proceeding. 52 ESPs do not believe that individual customer by customer information should be provided. Aggregate counts of customers should be sufficient. 53 This section was inserted after the 3/26/2004 conference call at the suggestion of Art Canning. No one has yet volunteered to write this section up. 54 Note that these proposals require selection of either Option (1) or (2) in Section II.b for all LSEs. 55 Since there are numerous publicly-owned utilities within the CAISO control area, this method requires that either the CEC or the CAISO require a comparable hourly load forecast from entities outside the CPUC's jurisdiction. The CEC has the legal authority to require such load forecasts for all "utilities" in California, and the CEC is currently evaluating whether it will resume such a requirement. 56 Page 6, CPUC Rulemaking 04-01-026; Order Instituting Rulemaking on policies and practices for the Commission's transmission assessment process. 57 Draft Resource and Transmission Adequacy Recommendations report, presented at the March 23-24, 2004 meeting of the NERC Resource and Transmission Adequacy Task Force. 58 The cumulative availability of twenty units with a 7.5% forced outage rate would be 21%--the ISO proposes that this is a reasonable cutoff that should be consistently applied in the analysis of large study areas with more than 20 units. Hydro units that are operated on a coordinated basis because of the hydrological dependencies should be moved together, even if some of the units are outside the study area, and could result in moving more than 20 units. 59 Determining a methodology for allocating import capability to LSEs was not an assignment of this working group. 60 Operational requirements of the various local areas (i.e., RMR areas) would need to be addressed so LSEs have the necessary information to develop their resource procurement plans. This includes operational requirements such as the amounts and locations of generation needed to be on line and the potential generation retirements that could increase local area requirements. The deliverability to load methodology should focus on these requirements.
